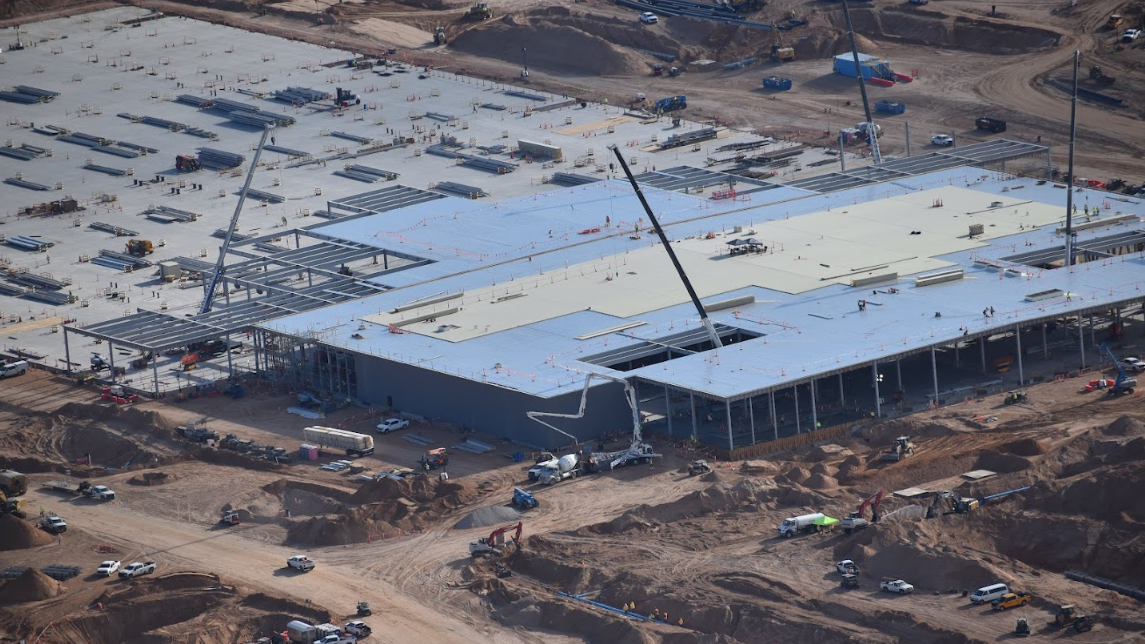

Hearing for Project Jupiter data center’s air quality permit application rescheduled to September
A public hearing on Project Jupiter’s air quality permit application has been rescheduled from Oct. 19 to Sept. 14 in Sunland Park.
The Sunland Park proceeding was previously scheduled for Oct. 19; the state’s Nov. 23 decision deadline remains unchanged
Joshua Bowling, Source New Mexico
This article was originally published by Source New Mexico.
A public hearing over whether the New Mexico Environment Department should issue an air quality permit for the controversial Project Jupiter data center is being rescheduled to September, according to newly filed documents.
The hearing officer presiding over the matter had previously scheduled the hearing to begin in October. At a scheduling meeting this week, attorneys representing Project Jupiter’s developers requested that the hearing begin earlier, arguing that the October hearing date would risk giving New Mexico Environment Department staff too little time to make a final decision on whether to issue the permit before their Nov. 23 deadline.
Max Shepherd, the hearing officer, told attorneys gathered at the scheduling hearing that he was not going to reschedule it. He said he would keep the October hearing date and examine his options to push out NMED’s Nov. 23 deadline.
However, two days later when NMED published his written scheduling order on its website, it showed he rescheduled the hearing by more than a month. It is now set to begin Sept. 14 and “continue as necessary” at the Sunland Park Multi-Generational Center.
“What happened between Monday morning, when he denied their motion for a new schedule, and Wednesday night?” Colin Cox, senior attorney at the Center for Biological Diversity’s Climate Law Institute, which has intervened in the case, told Source NM. “It’s highly concerning.”
Cox on Friday filed a new motion requesting that Shepherd revert back to the previously scheduled October hearing date.
Organ Mountain NewsJoshua Bowling
Maslyn Locke, senior attorney for the New Mexico Environmental Law Center, who has represented residents in lawsuits related to Project Jupiter, said the air quality permit case is among the most complex — and fast-moving — air quality complex cases she’s seen in her career. Under the revised scheduling order, she said attorneys will not have enough time to review the “thousands” of pages of the administrative record, catch their expert witnesses up to speed and prepare for oral arguments by the time the hearing begins in less than two months.
“Rushing this through is going to create more problems,” she said. “The department is neglecting the fact that once this thing is built, it’s really impossible to undo it.”
Shepherd, the hearing officer, when contacted by Source NM, said he could not comment on the rescheduling.
A spokesperson for the state Environment Department in a statement said the department “remains committed to meeting its statutory deadlines no matter the hearing date.”
At Monday’s scheduling meeting, Jennifer Bradfute, an attorney representing Project Jupiter developer Yucca Growth Infrastructure, argued that the hearing needs to happen as soon as possible.
Bradfute said her client would stand to lose $325 million per month, beginning in November.
“This project will start to abandon employment opportunities in New Mexico and there are many kids from the labor unions who want to be placed in jobs,” Bradfute said during the meeting. “We really do need this to go to hearing as soon as possible. The state is at jeopardy to lose the project entirely, and I’m not blowing smoke as I state that.”
At a Doña Ana County Board of Commissioners meeting earlier this week, Executive Vice President of Oracle Cloud Infrastructure Mahesh Thiagarajan and STACK Infrastructure Chief Development Officer Bobby Hollis presented the project’s latest job numbers days before an annual report on the matter was due.
Organ Mountain NewsDamien Willis
Hollis said at the meeting that the project employed nearly 700 New Mexicans during its ongoing construction. To date, it has employed nearly 2,800 construction workers and generated $734 million of contracts with New Mexico suppliers, according to their joint presentation.
The duo also told commissioners that they’re committing to 100% carbon-free energy matching by 2031.
County commissioners had previously set a Friday deadline for Project Jupiter’s developers to file an annual jobs report. However, that report was not readily available Friday afternoon.
In an email to Source NM, a Doña Ana County spokesperson said the report would contain personally identifying information for Project Jupiter employees and that county leaders “will be working with our legal team to get a form of the summary posted on the county’s website as soon as possible.”
Joshua Bowling is a senior reporter for Source New Mexico. He's reported in New Mexico, where he broke stories of lavish spending at Western New Mexico University and more, since 2022.
Keep Reading
Benjamin Alire Sáenz, acclaimed borderlands author and generous mentor, dies at 71 — The Las Cruces-born poet and novelist wrote across genres, refused easy definitions and encouraged younger writers to trust their own voices.
Army scholarship brings active-duty soldier to NMSU — Sgt. Jumaris Maduro will study psychology and complete Army ROTC through the Green to Gold Program beginning this fall.
Free FYI+ after-school program enrolling Las Cruces students — The free program offers tutoring, STEM activities, arts and wellness programming for Las Cruces students in kindergarten through 12th grade.
